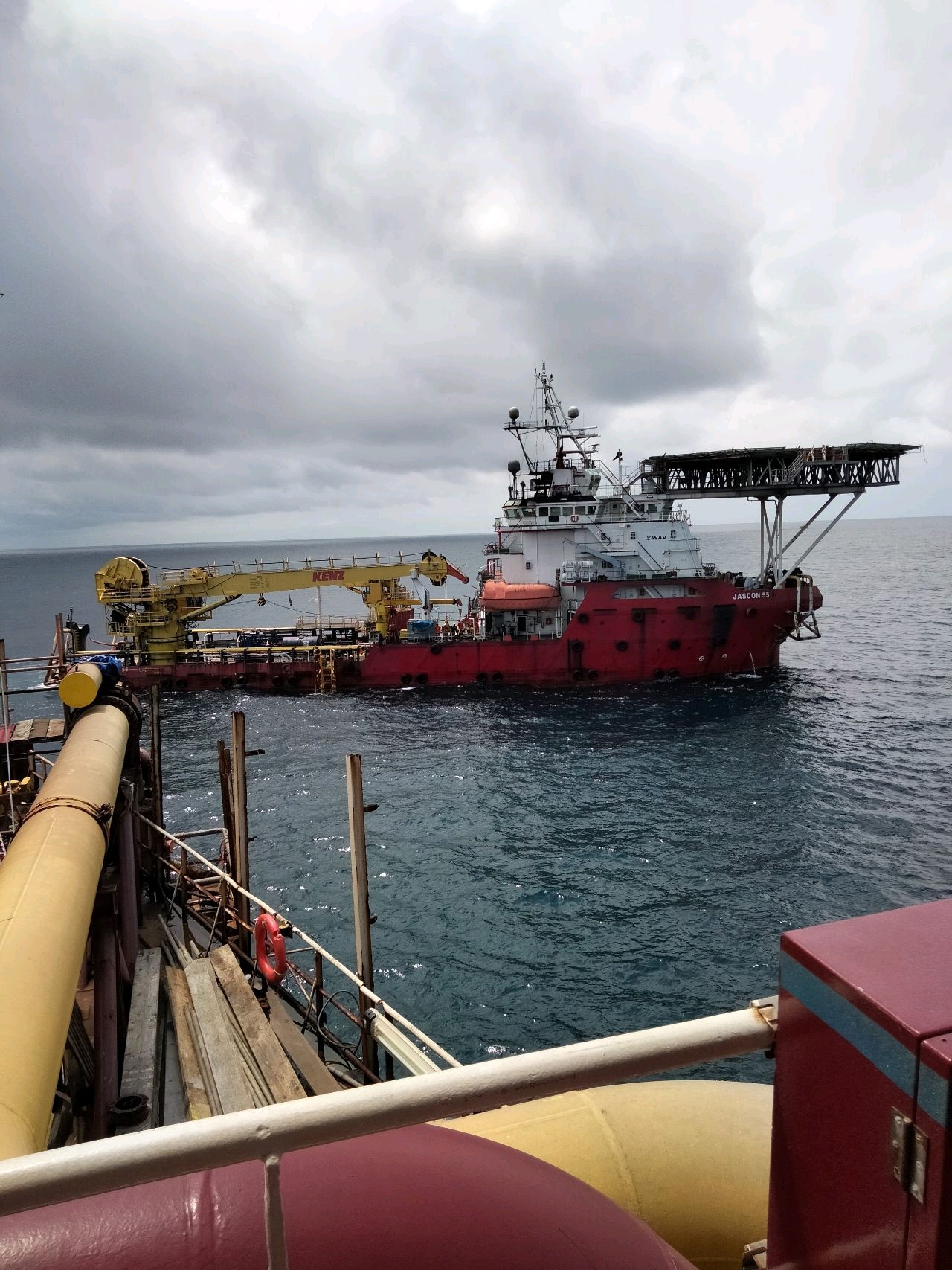

Offshore Pipeline - Brownfield

Subsea Flexible Pipelines

Subsea Flexible Pipelines
Client Nigerian Petroleum Development Company
Contractor Melcurt Nigeria Limited
Project Type Offshore Pipeline - Brownfield
Project Year 2019
Project Status Completed

12'' & 6'' Okpoho-Okono Subsea Flexible Pipelines Project (EPCIC) at OML 119 - Scope of Works

  • 01Flushing/De-oiling, Disconnection, Removal and Disposal of existing 16” Production Pigging Facilities on Okpoho WHP and FPSO Mystras.
  • 02Flushing/De-oiling, Disconnection, Removal and Disposal of existing 16” Production Riser Flexible and 8” Gas Lift riser flexible at the FPSO end between FPSO & SSIV Structure (MWA to remain in place).
  • 03Removal of existing SSIV structure at the FPSO end and associated spools between Pipeline & SSIV.
  • 04Removal of existing SSIV at the WHP end and associated spools between Pipeline & SSIV Structure and SSIV Structure & WHP Base of Risers.
  • 05Flushing/De-oiling, Disconnection (but not removal) of existing 16” production pipeline and 8” Gas Lift Pipeline, left in situ with blind flanges and protection as agreed with Company.
  • 06Engineering, Design, Procurement, Supply, Construction, Installation, Testing, Protection, Stabilization and Commissioning of a new SSIV structure at the FPSO end.

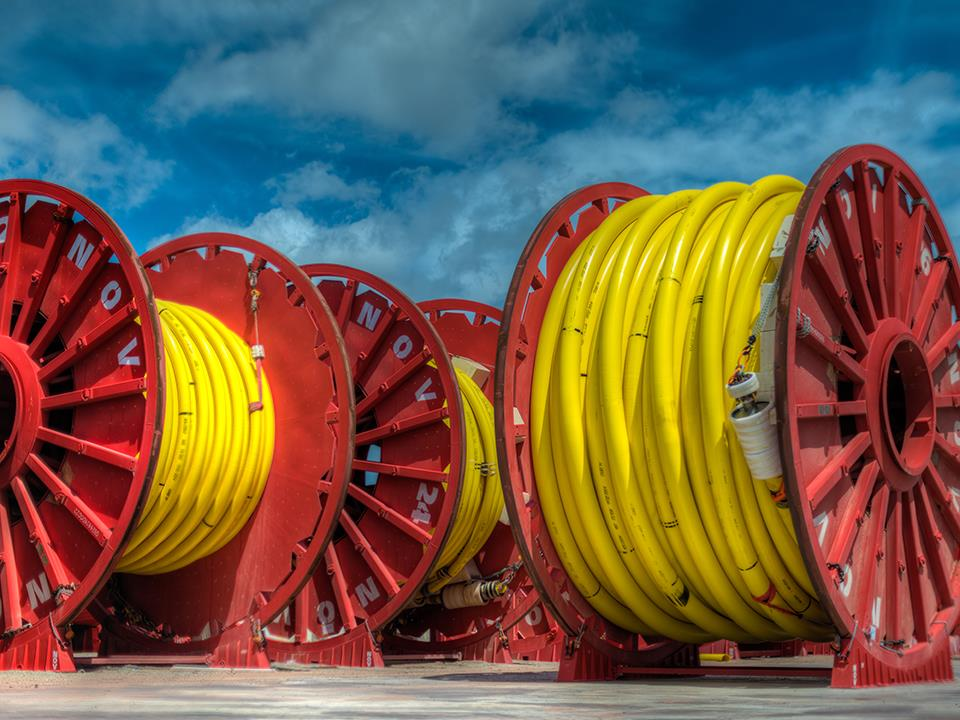

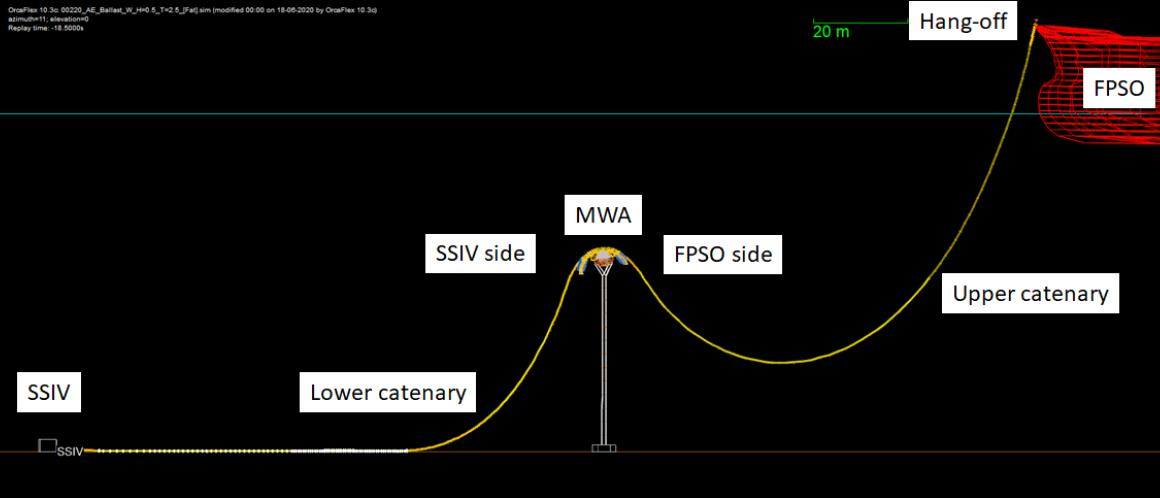

  • 07Installation of a new 12” Flexible Riser for Multiphase Production and a new 6” Flexible Riser for Gas Lift, from FPSO Mystras to the new FPSO SSIV Structure via the existing MWA.
  • 08Installation of a new SSIV structure at the WHP end and new 12”/6” Flexible Flowlines between the FPSO and WHP SSIV Structures.
  • 09Installation of a new retrofit riser system for 12” Multiphase Production & 6” Gas Lift from WHP SSIV Structure to WHP Topsides.
  • 10New temporary and permanent pigging facilities for the new subsea flexible pipeline systems on Okpoho WHP and FPSO Mystras.

GlintPM's Involvement - Project Planner/Engineer

  • 01Planned and generated schedule using Primavera (P6), tracked the schedule, re-baselined the schedule and generated monthly reports including project S-Curves for our client.
  • 02Supervised the delivery of subsea hardware (6'' & 12'' Flexible pipelines, SSIVs and associated Controls/structures), in accordance with NPDC's HSSE standards.
  • 03Managed cost, schedule/progress, quality and HSSE monitoring and reporting for all subsea hardware Engineering, Procurement and Installation activities showing detailed overall/individual S-Curves.
  • 04Monitored progress during preparation of Test Procedures with contractor Original Equipment Manufacturer (OEM).
  • 05Integrated and engaged all project interfaces at the FPSO, Subsurface, Wells, Operations, and Field Support Vessels.
  • 06Monitored and measured progress on the development of all engineering and construction procedures for the execution of the project.
  • 07Ensured that API 17J, DNVGL, ISO and NACE relevant codes/standards are strictly adhered to in the design and manufacture of the flexible pipelines.
  • 08Managed the supply chain management team to ensure robust processes are applied to the procurement phase, including selection and qualification of vendors/subcontractors, award of sub-contracts, and timely delivery of long-lead items.
View Contractor Website

Other Projects

Get In Touch

GlintPM would love to hear from you!

Let's work together!

Let GlintPM take on your project management assignments (schedule, cost and risk management) or excel works, and deliver quality service at an affordable price.

  • Schedule Management
  • Cost Control
  • Risk Management
  • Excel & Reporting
